Request a Demo

Coreworx-Logo-Positive

Interface Connect

Interface management software that
keeps delivery teams aligned

Interface Management Software

    Proarc-Logo-Positive

    Document Management

    Engineering document management
    system (EDMS) and document control software

    Document Management Software

      mpower-Logo-Positive

      Project Controls

      Project control and cost management software that provides complete control of project costs and drives better performance

      Project Controls & Cost Management Software

        Background Image
        Blog

        Project Controls Case Study: Streamline LEMs Time Tracking

        A Project Controls Case Study

        Attention project control professionals! Are you tired of the extensive time and effort required to aggregate all your project labor, equipment, and materials (LEMs) time tracking information and calculate all that data against complex rates in order to close your project and invoice your clients?

        Look no further – the following case study details how an EPC company managing a large oil and gas project implemented Mpower Project Controls software to overcome the typical issues faced when managing a project with a heavy focus on time and materials billing. While this case study is EPC-focused, project owners will also see parallels and gain insights they can apply to improve their own related project controls process.

        Project Overview

        This case study focuses on an EPC contractor who was a joint venture partner on a significant construction project in the global oil and gas sector. The project included one of the world’s deepest oil fields that, paired with a related field, were estimated to produce over 1 billion tons of total recoverable crude oil.

        Project Challenges

        Due to the sheer size of the project, the EPC required the collection, validation, and invoicing of over 5000 personnel and equipment items. The project included a mobilization plan of nearly 5000 time entries per shift, consisting of almost 3000 people and 2000 equipment items.

        An Overview of the Project's Time Tracking Requirements

        In addition to the volume of personnel and equipment items, many different rules and rates were applied for the calculation of the cost and price of the entered hours. For each timesheet entered, the following needed to be calculated:

        Labour Rates

        Equipment Rates

        COVID-19 Isolation – any timesheet entered for isolation should use these rates and ignore any others

        Standby in Warehouse – when not in use, equipment has a reduced standby rate that should be applied

        Cost + for Subcontracts – subcontracts are managed via cost + rates (cost + 22%)

        By Consecutive Usage – hourly, daily, weekly, monthly. Different rates apply if an equipment item is used for:

        • 30 consecutive days
        • 7 consecutive days
        • A single day, or
        • A fraction of a day

        The correct rate must be applied according to the usage of the equipment over the invoice period.

        Training – any timesheet entered against a training code should use the training rate and ignore any other

        By Consecutive Usage for 24 Hours – hourly, daily, weekly, monthly. As above, but another set of rates for equipment like generators which may be in use for 24 hours a day

        If none of the override rates are applied, then the rate which corresponds to the employee will be used:

        • Region
        • Grade
        • Shift
        • Location
        • Trade

        Solution: Project Controls Software

        Managing the extensive volume of hours (i.e. LEMs) data, in addition to managing the complexity of rates and calculations, was beyond the basic capabilities of manual tools such as spreadsheets. A comprehensive project controls software solution was essential to managing this level of data.

        Project Controls Software Requirements

        In terms of project controls software, the team needed a system that could:

        • Enable the accurate collection of large volumes of LEMs data
        • Track and calculate against pre-approved overtime rates
        • Produce weekly reports for discipline leads to approve the hours booked
        • Enable team members to track the mobilization plan versus actual mobilizations
        • Ensure data within the system is flexible and reusable
        • Leverage collected time data to validate that the estimates produced while scoping the project were accurate and revising norms and templates where necessary for the benefit of future projects
        • Provide visibility to project managers on productive and non-productive hours and where timesheets were coming in late – in the next period – or being amended from previous periods, all while maintaining audit trails of changes
        • Ensure accounting with valid data, first time, along with all the necessary backup information needed to issue an invoice
        • Able to instantly see approved time reflected against Level 2 budgets
        • Able to Integrate data with payroll and finance systems to drive the payroll process from actual hours

        After careful consideration, Mpower Project Controls & Cost Management Software was selected as the only solution capable of managing the complexity. Mpower’s Time Management process helps project-based organizations get control of timesheets for labor, equipment, and materials (LEMs) with multiple validation and approval stages available. With Mpower Time Management, actual hours data is available through the project hierarchy and easily integrated with third-party systems such as scheduling, payroll, and ERP systems.

        Mpower’s Time Management software met the EPC’s ultimate requirements for a solution to accommodate the sheer size of their project. With the introduction and implementation of this solution, its features and modules benefited every step of the time writing process. The following sections outline how Mpower Time Management software helped improve the EPC’s tracking and processing of LEMs data for the project.

        How Mpower Streamlined Time Writing

        The following sections outline how Mpower Time Management helped improve the EPC’s tracking and processing of LEMs data for the project.

        Time and Expense:

        Using Mpower’s integration tool, LEMs data was refreshed weekly with start date, position, skill, and location data being regularly updated. Mpower also auto-generated weekly timesheets for all equipment using movement applications, resulting in a timekeeper only needing to review the resulting data before submission.

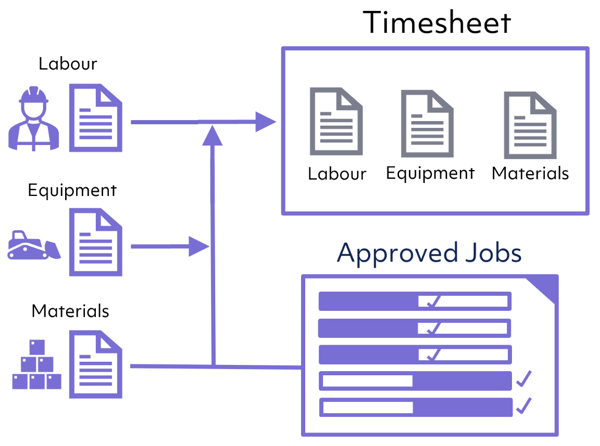

        Mpower generated weekly timesheets for the project's LEMs data

        Mpower’s HR/Employee application was beneficial too, allowing personnel data such as certifications or training requirements to be managed and tracked.

        Approval, Processing, and Invoices:

        Mpower’s timesheet data reports process helped ensure the end of the monthly period only had one week’s worth of data to be reviewed and approved, reducing the time between period end and the invoice issued.

        Mpower_Operating_Unit_Status

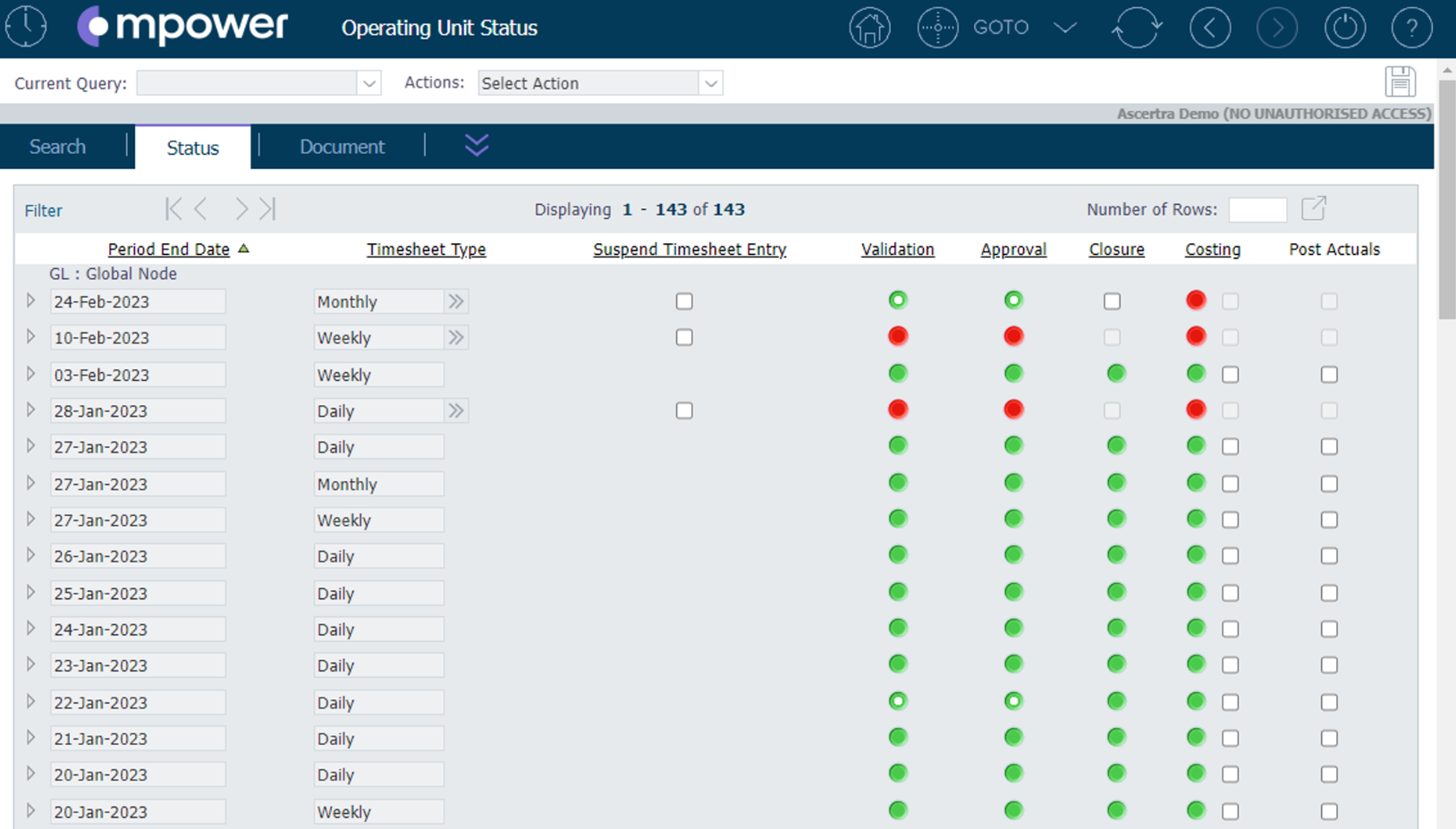

        Figure 1: Operating Unit Status for Timesheets

        Cost Rates:

        Mpower’s calculations of cost rates resulted in cost calculations that allowed the EPC to compare the value with the price of time and analyze which areas were the most profitable.

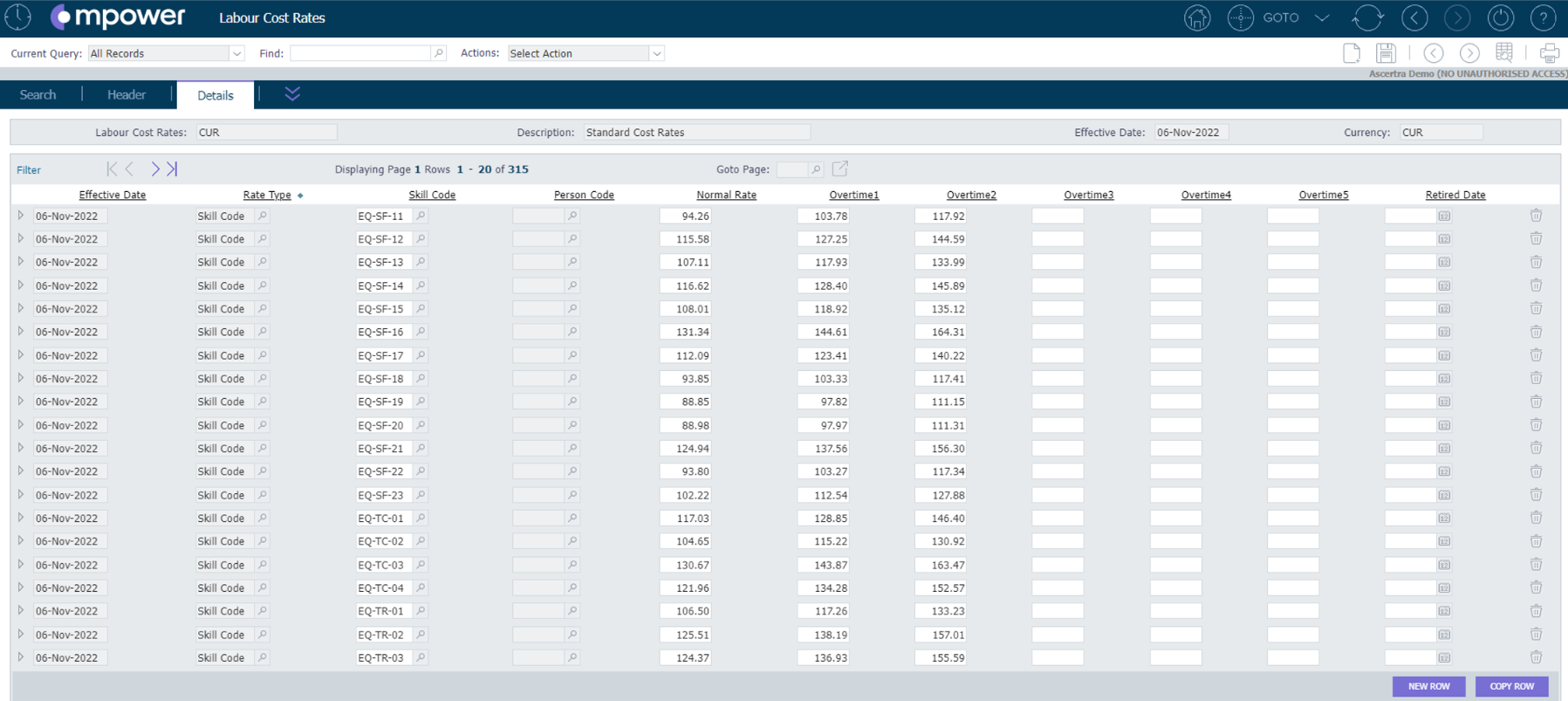

        Mpower_Labour_Cost_Rates_DashboardFigure 2: Labour Cost Rates Dashboard

        Following the weekly timesheet process ensured they had one week from period end to validate, letting them generate an invoice quickly with what they knew was quality data.

        Charge Rates:

        Within Mpower, charge rates, which allowed the calculation of the price of time, were defined in line with the schedule of rates agreed with the client.

        Mpower_Labour_Charge_Rates_Dashboard

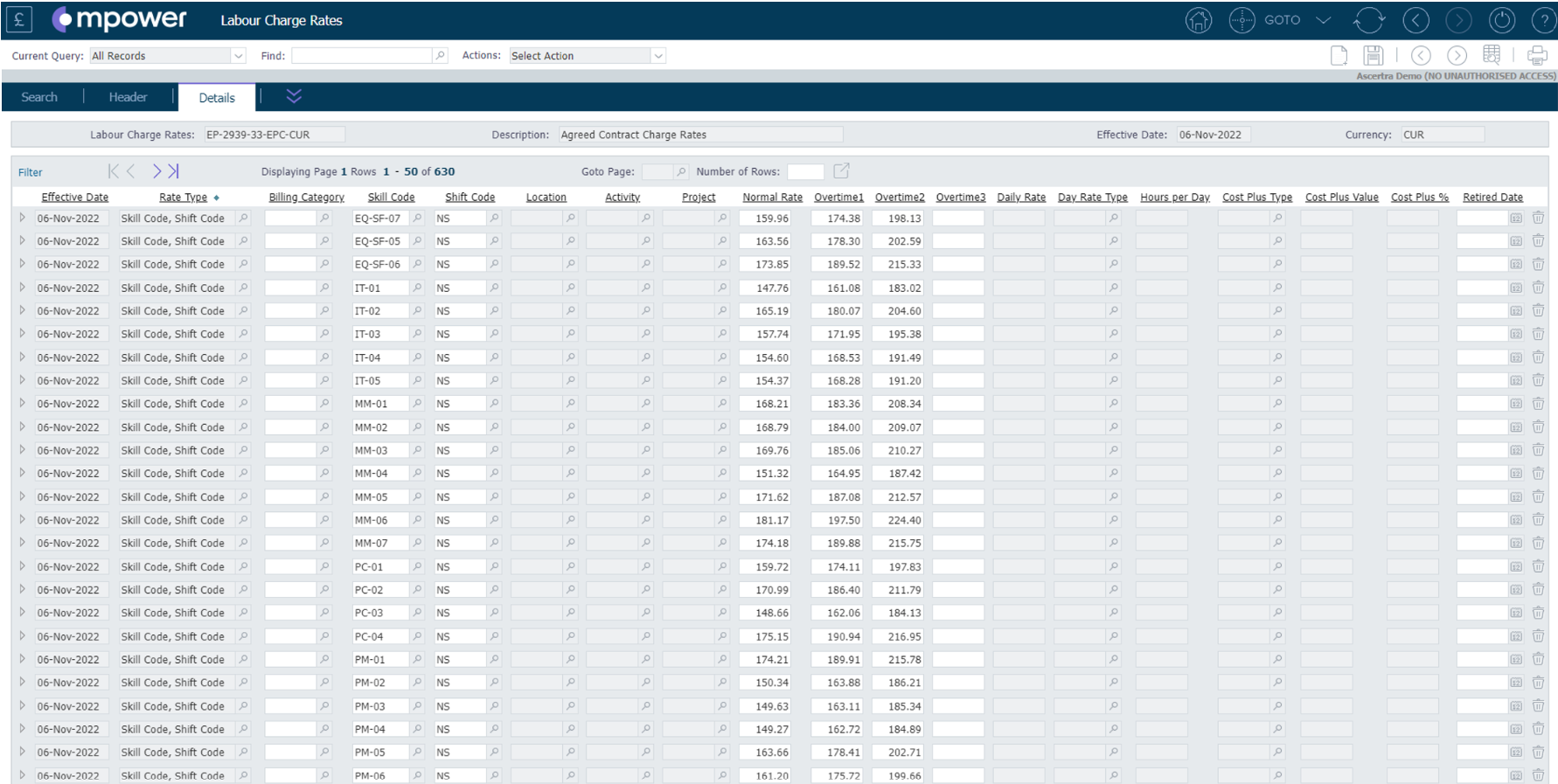

        Figure 3: Labour Charge Rates Dashboard

        Invoices:

        Using approved and priced timesheets, invoices could be created and reports issued from the single data set entered by a timekeeper or material coordinator. With timesheet data completed in time for the period end, the project team could look forward and react to performance. They now had the time to be proactive.

        Invoices created from Approved and Priced Timesheets

        Learn More on Project Time Tracking

        This blog post provides an overview summary of this case study. For an in-depth look at how this EPC company implemented time writing on their project to get better control of their LEMs data and ultimately accelerate project close and invoicing, watch the Streamline Time Writing & Accelerate Invoicing webinar now.

        Mpower_Time_Writing_Recording_Featured_Image

        Looking to learn more about how Mpower Project Controls and Cost Management software helps teams manage volumes of complex cost and performance data across major projects? Contact us or request a demo to get a custom tour of our Mpower software.

        Ready to make reliable information the center
        of your projects and operations to minimize
        risk and deliver quality results every time?
        Speak to one of our experts to choose the solution that will help you
        achieve your business goals
        Request a Demo
